Snowy 2.0
Share

Construction at Snowy 2.0, the next phase of the Snowy Mountains Hydro-electric Scheme, is continuing to advance, with a series of project milestones recently recorded.

Snowy 2.0 is a pumped-hydro expansion of the existing scheme, which involves the construction of new tunnels, power stations, and other infrastructure to increase the scheme’s generating capacity and energy storage capacity.

Progress on the construction of Snowy 2.0 continues across multiple worksites:

  • At Lobs Hole, tunnel boring machine (TBM) Lady Eileen Hudson has completed excavation of the 2.7km main access tunnel
  • TBM Kirsten is almost finished excavating the adjacent 2.9km emergency, cable and ventilation tunnel (ECVT)
  • At Tantangara, the project team is currently conducting works to stabilise encountered soft ground and enable TBM Florence to restart excavating the headrace tunnel
  • TBM Florence has tunnelled about 150m and is currently located at a depth of approximately 30 metres below ground.

A surface depression recently emerged in the ground above TBM Florence, which has temporarily delayed progress on this particular worksite. The depression is approximately nine metres deep and continues to be monitored.

The integrity of the tunnel, which is supported by a concrete lining and steel ribs, has not been compromised, and nor has the capacity of the TBM. The project team has paused the machine until about 10-15m of weak material in front of it is stabilised, prior to striking hard rock, when we expect normal tunnelling to resume.

Snowy 2.0 principal contractor Future Generation Joint Venture (FGJV) is drilling probe holes through the front of the excavation to understand the ground conditions immediately ahead of the TBM. Grout is injected in front of the excavation to improve any weak zones and limit any water flows. Grouting is well underway from TBM Florence, with 20 grout holes drilled to date in the current location.

FGJV is currently installing a slurry plant for the TBM that will mean the machine can switch from open excavation to a closed, pressurised mode. This will deliver stable excavation and efficient progress through the softer ground conditions, while enabling the TBM to switch back to open mode when in harder rock.

Stage two of the works to stabilise the ground in front and above the machine will involve ground improvement from the surface. Once the area is grouted, the depression will be backfilled and revegetated.

Snowy Hydro has been responsibly operating the Snowy Scheme in Kosciuszko National Park for decades and remains committed to careful and safe management of this tunnelling challenge in a sensitive environment.

The Snowy 2.0 workforce of more than 2,200 is continuing to achieve milestones across a range of work fronts as they build the huge pumped-hydro expansion of the Snowy Scheme.

At Lobs Hole, in the main access tunnel, works are continuing on multiple drill and blast cross tunnels. These will link with the ECVT, where TBM Kirsten has tunnelled 2.8km and has reached the site of the underground power station cavern complex. This is a great milestone for Snowy Hydro as we now have access to the excavation site from both ends of the cavern, which will be one of the largest and deepest in the world.

TBM Kirsten is setting a global standard in tunnel boring technology, just as the original Snowy Scheme developed rock bolting techniques that are still used throughout the world. The machine will soon be modified to excavate the inclined pressure shaft on a steep uphill angle. Modifications include altering the levels of the TBM’s tanks and mechanical equipment so they are level when travelling up the 25-degree incline, and converting the walkways on the machine’s sides into steps and ladderways.

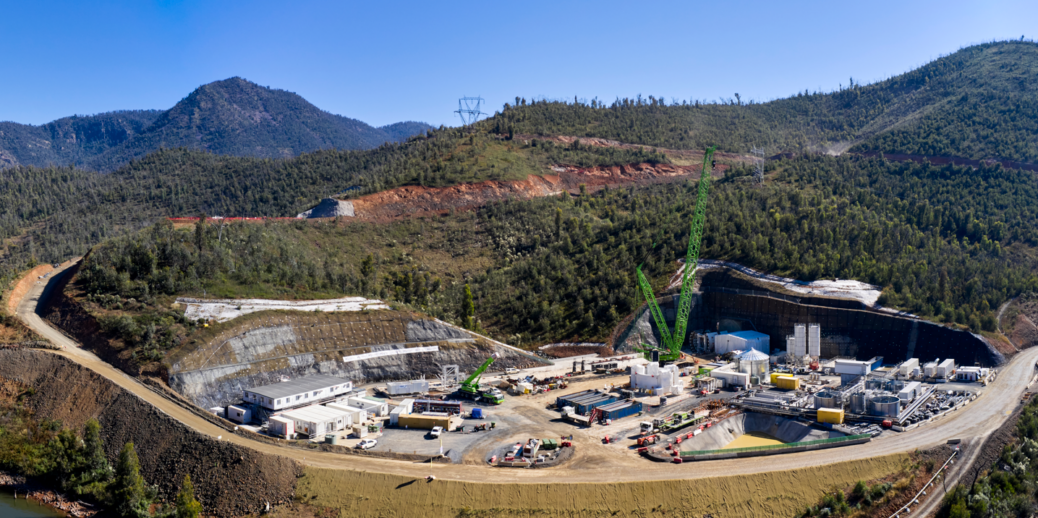

Meanwhile TBM Lady Eileen Hudson is being reassembled at the Talbingo adit with some new components including a cutterhead and shields. It will be launched into the mountain late 2023 to excavate the 6km tailrace tunnel, which will feed into Talbingo Reservoir.

Excavation of intakes at Talbingo and Tantangara is advancing steadily, along with the giant surge shaft on the Marica plateau that is already excavated to a depth of more than 20m.

Despite the ongoing challenges faced by all large infrastructure projects, Snowy 2.0 continues to achieve progress across a large number of remote work fronts.

Snowy Hydro remains fully committed to ensuring the local community and stakeholders are kept updated on this pumped-hydro mega project that will provide the National Electricity Market with 2,000MW of on-demand generating capacity and a huge 175 hours of energy storage.

Feature image: TBM Lady Eileen Hudson being reassembled for excavation of the tailrace tunnel. Provided by Snowy Hydro.

Related articles
0 Comments

Leave a reply

Your email address will not be published. Required fields are marked *

*

©2023 Energy Magazine. All rights reserved

CONTACT US

We're not around right now. But you can send us an email and we'll get back to you, asap.

Sending

Log in with your credentials

Forgot your details?
